System Cleaning and Flushing

Cleaning and Flushing
Prior to start up of any heat pump, the water circulating system must be cleaned and
flushed of all dirt and debris.
If the system is equipped with water shutoff valves, the supply and return
runouts must be connected together at each unit location (This will prevent the
introduction of dirt into the unit, see Figure 7). The system should be filled at
the water make-up connection with all air vents open. After filling, vents should
be closed.
The contractor should start the main circulator with the pressure reducing valve
makeup open. Vents should be checked in sequence to bleed off any trapped
air and to verify circulation through all components of the system.
As water circulates through the system, the contractor should check and repair
any leaks found in the piping system. Drain(s) at the lowest point(s) in the
system should be opened for initial flush and blowdown, making sure water fill
valves are set at the same rate. Check the pressure gauge at the pump suction
and manually adjust the make-up water valve to hold the same positive pressure both before and after opening the drain valves. Flushing
should continue for at least two hours, or longer if required, until drain water is clean and clear.
The supplemental heater and/or circulator pump, if used, should be shut off. All drains and vents should be opened to completely drain the
system. Short-circuited supply and return runouts should now be connected to the unit supply and return connections.
Refill the system with clean water. Test the system water for acidity and treat as required to leave the water slightly alkaline (pH 7.5 to 8.5).
The specified percentage of antifreeze may also be added at this time. Use commercial grade antifreeze designed for HVAC systems only.
Environol™ brand antifreeze is recommended..
Once the system has been filled with clean water and antifreeze (if used), precautions should be taken to protect the system from dirty
water conditions. Dirty water will result in system-wide degradation of performance, and solids may clog valves, strainers, flow regulators,
etc. Additionally, the heat exchanger may become clogged which reduces compressor service life and can cause premature unit failure.
In boiler/tower application, set the loop control panel set points to desired temperatures. Supply power to all motors and start the
circulating pumps. After full flow has been established through all components including the heat rejector (regardless of season), air
vented and loop temperatures stabilized, each of the units will be ready for check, test and start up and for air and water balancing.
Ground Source Loop System Checkout
Once piping is completed between the unit pumping system and ground loop, final purging and charging of the loop is needed. A high
pressure pump is needed to achieve adequate flow velocity in the loop to purge air and dirt particles from the loop itself. Antifreeze
solution is used in most areas to prevent freezing. Flush the system adequately to remove as much air as possible; then pressurize the
loop to a static pressure of 40-50 PSI (summer) or 50-75 PSI (winter). This is normally adequate for good system operation. Loop static
pressure may decrease soon after initial installation, due to pipe expansion and loop temperature change. Running the unit for at least 30
minutes after the system has been completely purged of air will allow for the "break-in" period. It may be necessary to adjust static loop
pressure (by adding water) after the unit has run for the first time. Loop static pressure will also fluctuate with the seasons. Pressures will
be higher in the winter months than during the cooling season. This fluctuation is normal and should be considered when charging the
system initially.
Ensure the pump provides adequate flow through the unit by checking pressure drop across the heat exchanger.
Usually 2.25-3.0 GPM of flow per ton of cooling capacity is recommended in earth loop applications.

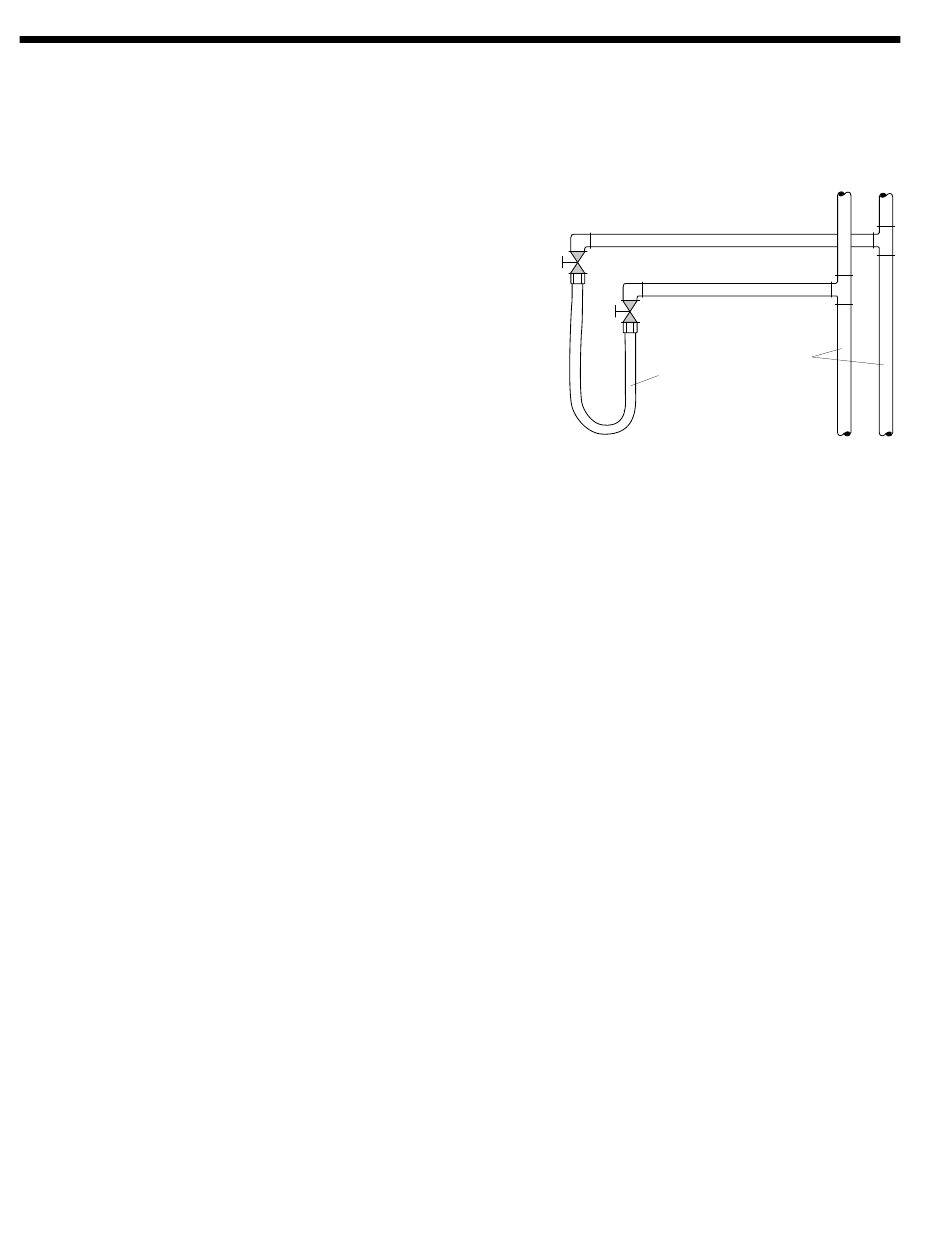

Figure 7: Flushing with Water
