Test Data and Performance Curves
3.2 Waveforms
CH 1 ( VIN )
CH 2 ( VOUT )
CH 3 ( PG )

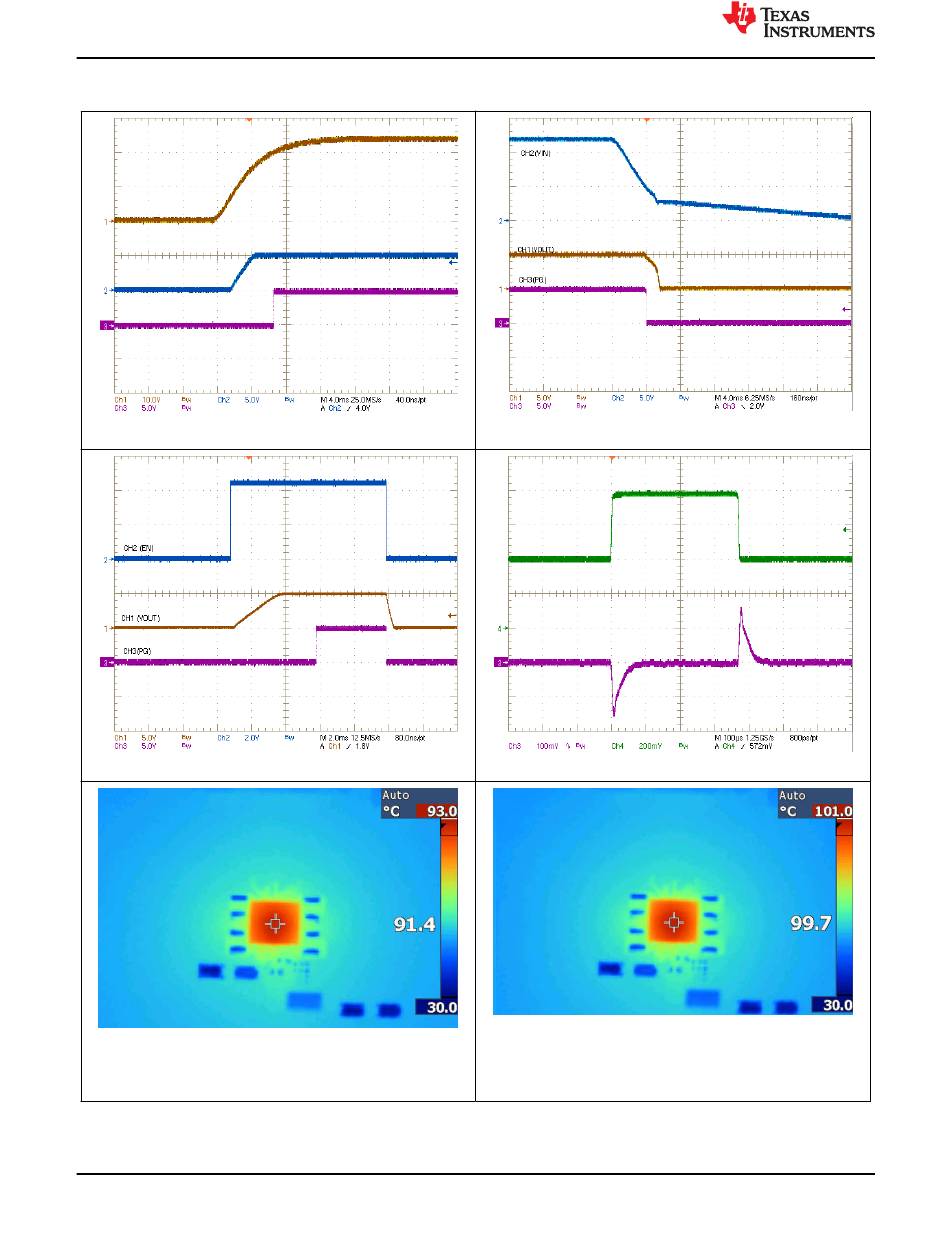

Figure 3-5. Start-Up to V
Figure 3-7. Enable ON and OFF
F
= 1 MHz
I
SW
OUT
Figure 3-9. Infrared Thermal Image V
8
TLVM13610EVM Buck Regulator Evaluation Module
= 24 V
IN
= 8 A
P
= 3.49 W
DIS
= 12 V, V
IN
= 5 V
Copyright © 2023 Texas Instruments Incorporated
Figure 3-6. Shutdown
CH 4 ( IOUT )
CH 3 ( VOUT )
Figure 3-8. Load Transient, 4 A to 8 A at 1 A/µs
F
= 1 MHz
SW
Figure 3-10. Infrared Thermal Image V
OUT
www.ti.com
I
= 8 A
P
= 4.06 W
OUT
DIS
= 24 V,
IN
V
= 5 V
OUT
