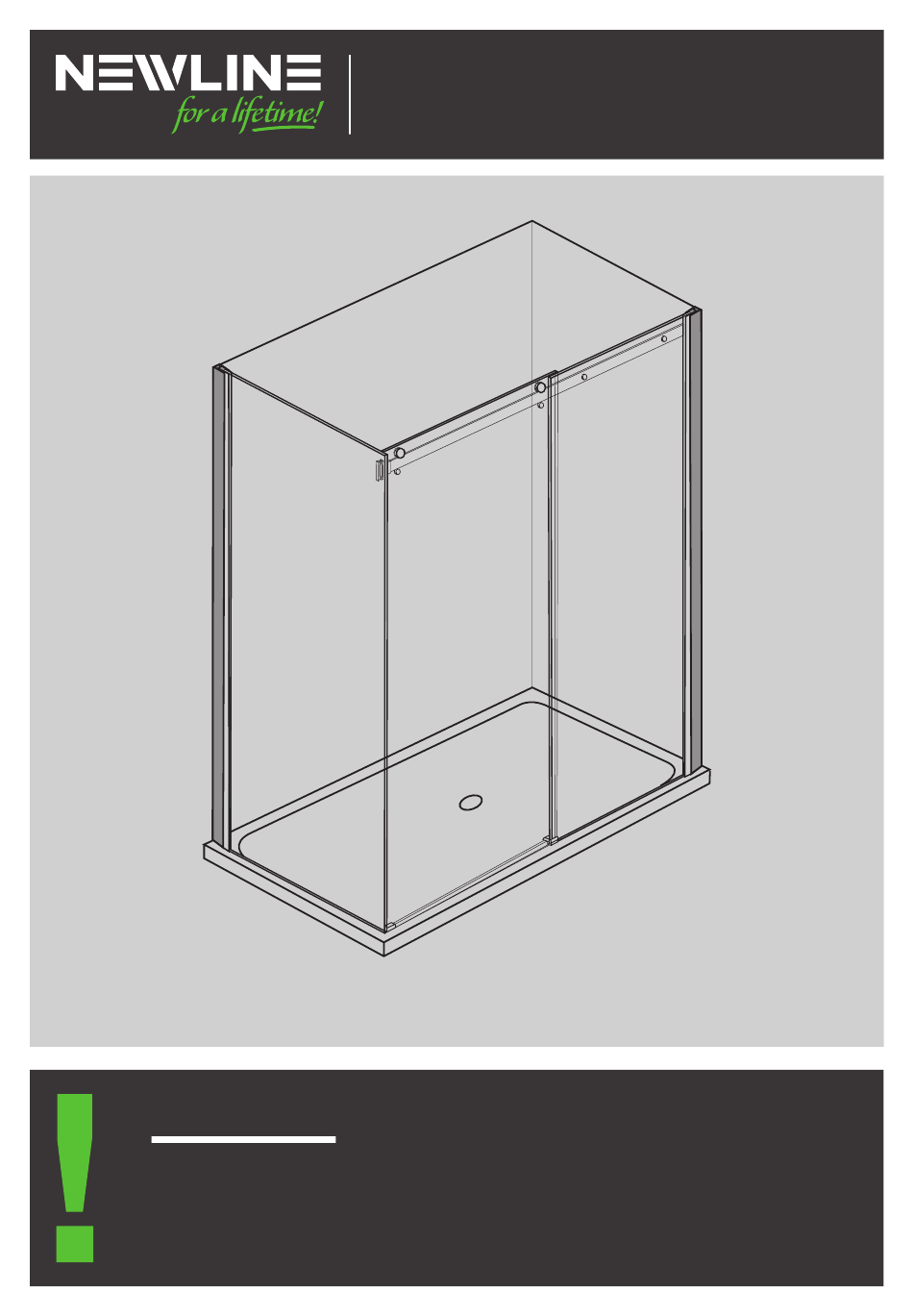

Page 1
Important! 1. When you receive your Anita shower check contents for any freight damage of defect. 2. Advise Newline on 0508 639 5463 if any damage has occurred within 8 hours of receiving the goods so this is can rectified.
HEALTH AND SAFETY Toughened Glass: • Do not rework pre-cut glass panels. Cutting or altering a glass panel will cause it to explode without warning. • Unpack all glass assemblies. Stand glass on soft packaging when it is on the floor and against a wall. Care must be taken not to strike any edge or corner against a hard surface as this will chip and destroy the glass panel. Installation: • Glass panels and assemblies are heavy. Two man lifting is recommended for handling and installation. • Determine positioning of wiring and piping within wall cavities before shower installation. Mark their positions to ensure electrical and piping areas are avoided. • Wear appropriate protective clothing and eye protection during installation. TOOLS REQUIRED AFTERCARE • The shower must be squeegeed down after each shower. Thoroughly clean weekly with a microfiber cloth, mild detergent and water. Rinse with clean water and squeegee and wiped dry. NEWLINE RECOMMENDS A SKILLED TRADESMAN ACQUAINTED WITH SHOWER INSTALLATIONS IS USED TO ENSURE THE VERY BEST OUTCOME.
1. Newline requires the use of complete systems by licenced/trained applicators. Waterproofing, Tile Adhesive, Grouting and Silicone detailing for full accountability and performance requirements. 2. The tiles must conform to gradients provide with the “ProFinish Tile Tray” to comply to NZ Building Code. 3. The line where shower frame sits must be level for an acceptable install of the shower. ANITA SHOWER - SELECTING THE CORRECT LAYOUT PLAN There are four layout pages provided. Please ensure you select the correct layout page and combine this with the installation details. Page 3 2 Exploded View Assembly Diagram...
Page 4
ANITA SHOWER - ASSEMBLY DIAGRAM REF. DESCRIPTION PART NO. REF. DESCRIPTION PART NO. Wall Profile Rail K8618 H8601 Return panel Rail joiner assembly K0970 Door panel Wall gaskets K1342 Buffer strip Wall cap I6105 K1359 Buffer/seal strip Front fixed panel I8526 Handle set Water deflector H8533 I8595 Screw Pack Lock in knob sets (door) K1519 K0895 Front glass to rail fixing...
Page 5
IMPORTANT DETAIL DOTTED LINE: OUTER CHANNEL BOUNDARY LINE RETURN GLASS EDGE: 5MM BACK FROM DOTTED LINE OPTION A: ANITA ACRYLIC SHOWER (APPLIES TO 1200 X 900) Anita Acrylic Shower with Newline Acrylic Tray and ABS/Acrylic Liner: Set out the Anita Shower by marking out the outside line of the wall channels (A) 12mm in from the outside edge of the tray. This will allow for suitable placement of the shower plus some variances from plumb on the walls. Greater variances will need to be calculated in the layout. MINIMUM / MAXIMUM TABLE SHOWER TYPE...
Page 6
ANITA SHOWER: TILE WITH PROFINISH TILE TRAY - LAYOUT PLAN B NOTE: All measurements assume the floor is level, the walls are plumb and all surfaces are flat. Any variation must be adjusted for in the measurements provided. IMPORTANT DETAIL MINIMUM / MAX SHOWER TYPE 1200 x 900 DOTTED LINE: OUTER CHANNEL BOUNDARY LINE RETURN GLASS EDGE: 5MM BACK FROM DOTTED LINE OPTION B: ANITA TILE SHOWER WITH PROFINISH TILE TRAY...
Page 7
ANITA ALCOVE (DOOR ONLY) - LAYOUT PLAN C Rail Joiner: OPTION C: ANITA ALCOVE (1200 DOOR SET) WITH TILE Mounted L/H or BASE AND ACRYLIC BASE APPLICATIONS R/H only Depth The following table covers the Door Size with the Minimum and Maximum Range. Care must be taken if using the Dotted Line: minimum or maximum measurements as discrepancies in Outer boundary the walls or base may not allow for this. SHOWER DOOR TYPE FRONT DOOR PANEL MIN/MAX...
Page 8
ANITA SHOWER - INSTALLATION INSTRUCTIONS Identify the specific Layout Plan applicable to your specific shower. Use the correct Layout Plan in conjunction with the installation instructions. Mark out the wall channels taking into account the guidance notes. Acrlyic: Pre-drill lead holes in the wall lining matching up to the Channel holes. TILE: Bond the wall channels to the tiles with Bostik V60. (Refer back to tile layout page re-penetration of waterproofing) Apply silicone to the back of the channel and fix in place with the M4 x 35 screws ensuring that the channel remains plumb.
Page 9
Install rail bracket components (14, 15, 17 & 18) to return panel. Insert the rail (13) into return glass bracket and attached to the front panel with the two glass fixing pieces (8) and tighten these. Tighten the allen keys on the joiner (15) to the rail (13) when the return glass is at 90 degrees off wall.
Page 10
Install the roller sets (12) to door panel (3). Rollers should be on the outside of the door. Fit water deflector on bottom edge of door. Hang the door on the rail from inside of the shower. Carefully slide the door toward the return panel and check the gap between door and return panel is even.
Page 11
Plumb the ends of the glass. On the inside of shower drill 3.2mm holes through both the fixed panel profiles and into the wall channels (NOTE: Ensure that the chosen position avoids drilling through the glass - see Diagram 5.1). Screw together using M4 Screws (21). Cover the screws with screw cover caps (22).
Page 12
Apply high quality neutral cure silicone to the outside. DO NOT USE SHOWER FOR 24 HOURS 24 HOURS Silicone is not used on the inside of the shower screen because water can build up over time within the wall channel and leak out of the shower area. The screen is designed to allow the water to return into the shower area, if any is present. SCREENS THAT ARE SEALED ON THE INSIDE WILL VOID WARRANTY. Freephone: 0508 639 5463 Phone: 09 444 2053 Fax: 09 443 0044 Email: info@newline.co.nz www.newline.co.nz...
